Rejected on day 1, reported on day 9
第 1 天判退,第 9 天才傳到客戶手上
Nobody hid the defect. The paperwork simply took eight days, and by then the weld had already been repaired and coated.
沒有人隱瞞缺陷,只是文書流程走了八天。等客戶知道時,那道焊道早就補焊、塗裝完了。

The inspection that rejected the weld took place on day 1. The client, on the other side of the world, found out on day 9.
Nothing was hidden. The fabricator did not cover anything up and the inspector did the job properly: defect photographed, nonconformity issued, spreadsheet prepared that evening, weekly report submitted. Eight of those nine days were pure paper workflow. By the time the client was aware of the issue, the joint had already been repaired and coated.
Why eight days matters more than it sounds
A client who hears about a rejected weld on day 1 still has choices. They can ask to witness the repair, check the repair procedure, or request additional NDT before the joint is coated. A client who hears on day 9 has none of those options left. The decision has effectively been made for them.
That is why an ITP has hold and witness points. But a hold point only protects the client if the information reaches them before the work moves on. A reporting chain built on evening spreadsheets and weekly reports quietly turns every finding into a history lesson.
The delay is rarely anyone's fault. It is built into the workflow: photos on one phone, notes on paper, the NCR in a Word template, the summary in Excel, and a report that goes out weekly because compiling it takes a full day.
Six things that close the gap
This is the gap ProQ is designed to close.

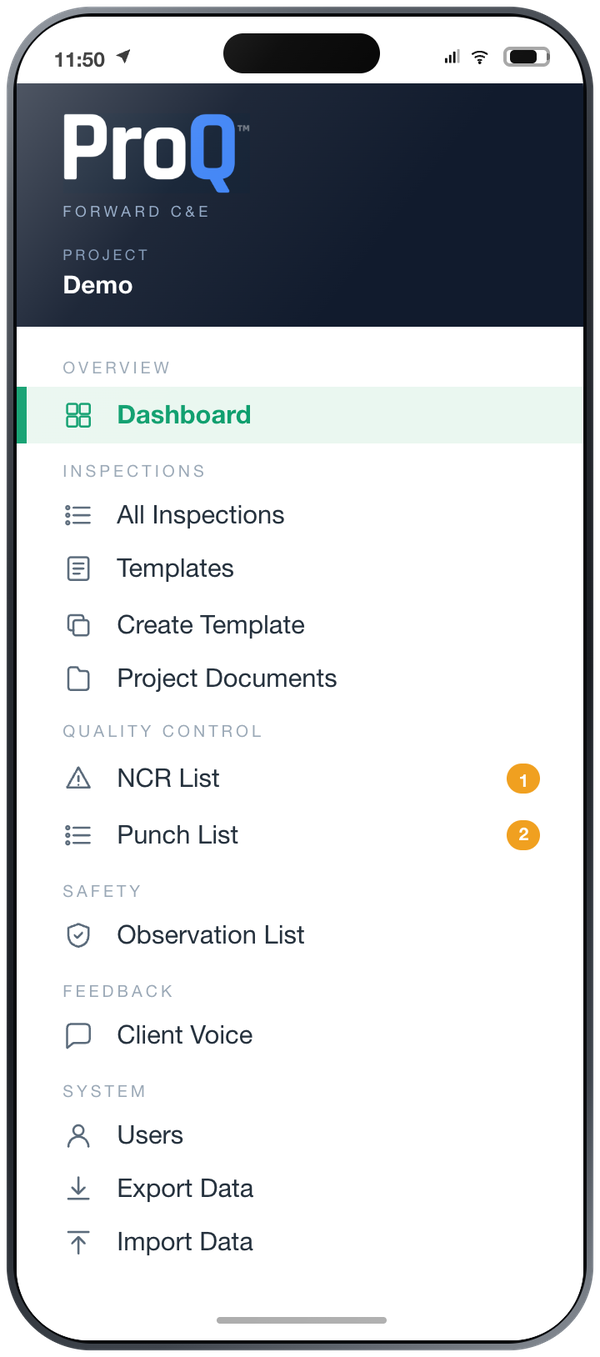

- Shoot and share in the same minute. The inspector photographs the joint on a phone at the workstation and the record is live. Each photo keeps its original capture time, so it stands as evidence, not decoration.
- Every stakeholder, any device. Client, EPC and plant manager open the same record wherever they are, with PDF preview and download on the spot.
- A dashboard that answers the three real questions. How far along is this project, who owns each hold, witness, monitoring and review point, and when was it signed off.
- Full traceability. Weld number, heat number and equipment number are tied to the same record instead of being scattered across four folders.
- Always the current revision. Drawings, procedures and ITPs are served at their latest version, so nobody inspects against a superseded document.
- Nothing falls behind. Open nonconformities, punch items and HSE observations are tracked through to closure.
Plan, inspect, correct, verify: ProQ keeps the whole PDCA loop in one platform, on a real fabrication shop floor rather than in a procedure binder.

On most projects I have seen, the time between an inspector seeing a problem and the client seeing it is measured in days. With the tools available today it should be measured in minutes.
判定焊道不合格的那次檢驗,發生在第 1 天。遠在地球另一端的客戶,第 9 天才知道。
沒有人隱瞞什麼。製造廠沒有掩蓋,檢驗員也確實做好了該做的事:拍下缺陷照片、開立不符合報告、當晚整理試算表、提交週報。這九天裡,有八天純粹花在文書流程上。等客戶知道這件事時,那道焊道早就補焊、塗裝完成了。
八天的延遲,影響比想像中大
第 1 天就知道焊道被判退的客戶,還有選擇:可以要求到場見證補焊、確認補焊程序,或是在塗裝前加做非破壞檢測。第 9 天才知道的客戶,這些選項全都沒了,等於決定已經替客戶做完。
這正是 ITP 要設停留點與見證點的原因。但停留點要保護得了客戶,前提是資訊得在工作往下走之前送到客戶手上。靠晚上整理試算表、每週交一次報告的流程,會悄悄把每一個發現都變成事後回顧。
這種延遲很少是誰的錯,而是流程本身就長這樣:照片在一支手機裡、筆記寫在紙上、不符合報告套 Word 範本、彙整用 Excel,而報告一週才交一次,是因為光彙整就要花掉一整天。
補上這個缺口的六件事
ProQ 就是為了補上這個缺口而設計的。
- 拍完同一分鐘就分享。檢驗員在工作站用手機拍下焊道,紀錄立即上線。每張照片都保留原始拍攝時間,是證據,不是裝飾。
- 所有相關方,任何裝置。業主、EPC、廠長不管人在哪裡,打開的都是同一筆紀錄,現場就能預覽與下載 PDF。
- 儀表板回答三個真正的問題。專案進行到哪裡、每個停留點、見證點、監督點與審查點由誰負責、什麼時候簽核。
- 完整追溯。焊道編號、爐號、設備編號都綁在同一筆紀錄,不再分散在四個資料夾。
- 永遠是最新版。圖面、程序書與 ITP 都以最新版提供,沒有人會拿作廢的文件去檢驗。
- 沒有漏網之魚。未結案的不符合、缺失與安全衛生觀察,一路追蹤到結案。
規劃、檢驗、矯正、驗證,ProQ 把整個 PDCA 循環放進同一個平台,落實在真實的製造現場,而不是只寫在程序書裡。

我看過的多數專案,從檢驗員看到問題到客戶看到問題,時間是用「天」來算的。以現在的工具,這段時間應該用「分鐘」來算。
